Product Owner

Cost Calculations for Issues and Projects

Design a structure for calculating what it will cost to complete each Story, Epic, or other grouping of issues, based on the amount of time remaining and the hourly rate of the assignee.

Requirements

For this method to be successful, you need:

  • All stories and tasks assigned to specific Jira users
  • custom User property containing each user's hourly rate of pay (we've named ours "cost")

Step 1: Build a Hierarchy

Build a structure with an Epic > Story > Sub-task hierarchy:

  1. Go to the Jira menu and select Structure | Create Structure
  2. Add epics: Automation | Insert | JQL Query and enter the following JQL query: issuetype = Epic
    1. To limit the epics to specific projects or other variables, add additional specifications (Example: AND project = "My Epics")
  3. Add stories: Automation | Extend | Stories under Epics...
  4. Add sub-tasks (optional): Automation | Extend | Sub-tasks...


There are many ways to build your hierarchy, depending on what values you want to track. For more ideas, check out some of our other Task Articles or our Generators docs.

Step 2: Add a Column for the Custom User Property

  1. Open the Add Column menu (+) and select Attribute...
    Add Attribute Column
  2.  Under the column properties, enter the following values:
    • Attribute: User Property...
    • User Field: Assignee
    • Property: Enter the key for the user property where you store each user's hourly pay rate - ours is called "cost"

You should now have an Assignee(cost) column that displays the values from our custom user property:

Structure with custom user property for cost

Step 3: Calculate the Cost to Finish Each Issue (epic/story/etc.)

Add a formula column to calculate the cost to finish each issue in our structure. Enter the following:

  • Formula: AssigneeCost*RemainingEstimate/3600000
  • Variables: map AssigneeCost to the custom "cost" property we discussed in Step 2 - see Columns as Variables for more details
  • Check Sum over sub-items so the cost is aggregated up the hierarchy
  • If issues or tasks appear multiple times within an epic (or other grouping), check Exclude deplicates to avoid an inflated total costs

Calculate Remaining Cost with a Formula Column

Bonus - Make This Information Visible Outside of Structure

Using Effectors, we can write the values from our formula to a custom Jira field, making them visible to users outside of Structure.

 Before we start, you'll need to make sure you have a custom field where the Cost-to-Complete values can be stored. We created a custom field called "FinishCost".

Add an Effector

Open the Automation menu and select Effectors.

Add Effector

Choose Attribute to issue field...

Attribute to Issue Field Effector

On the Effector settings screen:

  • The name field is updated automatically as you select the Effector properties. If you prefer, you can also click the edit button to enter a custom name.
  • Get Value From: select the formula column we added in Step 2
  • Set Value To: select the custom Jira field you want to write the cost-to-complete values to
  • Limit To: If you only want to write cost data for certain issues or issue types (for example, just for epics), enter the appropriate JQL. We've left this section blank, because we want to write values for all issues.
  • Select whether email notifications should be sent when the Effector writes values to Jira

Effector Settings

When you're finished, click Save and Run to run the Effector immediately, or click Save to simply add the Effector to the structure but not run it yet.

Run the Effector

You can run an Effector directly from its settings screen (see above), or you can locate the Effector at the top of the structure and click the Action button (the three dots to the right of its row). Select Run.

Run effector

You have the option to Preview effects before applying. This allows you to view and approve every change that will be made by the Effector. Effectors update live Jira data, so we highly recommend using the preview option. Click Run to begin.

Run effector screen

Once the preview is finished, you will see a list of changes that will be made by the Effector. You can select which changes you want made, or click Apply All to apply all changes.

Select Effector changes to apply

Once you apply the selected changes, the cost values from your formula column will be written to the custom Jira field, where they can be viewed outside of Structure.

Values written to Jira custom field


Custom Reports

With Structure, you can easily create a visual overview of your projects – and visualize all the data you need to track on a single screen.

Step 1: Build Your Structure

To create a new structure:

  • Go to the Jira menu and select Structure | Create Structure
  • Add the issues you want to track – you can add them manually or automatically using Automation | Insert
  • Add related issues - you can do this using Automation | Group and Automation | Extend

Step 2: Add Data

Next, add the data you need to track by clicking the button at the top-right corner of the structure. You can add as many columns as you need, including:

  • Jira fields, such as status, assignee, sprint, or remaining estimate
  • Progress - track status based on issue progress, percent completion, or resolution
  • Tempo Work Logged - track how long your team is spending on each issue
  • Formulas - create your own formulas to compare fields or create a visual report
  • Time in Status - see how much time issues spend in a particular status

  • Last Comment - view the latest comment for each issue

Once you've added your columns, you can aggregate the data up the structure. To do so, open the column you want to aggregate and select Sum over sub-items.

Looking to visualize your structure data as a chart or other report? Our integration with Custom Charts for Jira makes it easy to build customizable charts from your structure data. Learn more


Release Management

With Structure, you can track all the issues for upcoming releases – even if they're from different projects – and visualize all the data you need to track on a single screen.

Step 1: Build a Release Management Structure

To create a structure for release management:

  1. Go to the Jira menu and select Structure | Create Structure

  2. Add the issues you want to track – you can add them manually or automatically using Automation | Insert

  3. Group issues by fix version: Automation | Group | type "Fix Version/s" (Tip: If you use the same names in different projects, use "Version name..." instead.)

  4. Open the Summary settings and select Show Sprint and Version attributes

Step 2: Add Data

Next, add the data you need to track by clicking the button at the top-right corner of the structure. You can add as many columns as you need, including:

  • Jira fields, such as status, assignee, sprint, or remaining estimate
  • Progress - track status based on issue progress, percent completion, or resolution
  • Tempo Work Logged - track how long your team is spending on each issue
  • Formulas - create your own formulas to compare fields or create a visual report
  • Time in Status - see how much time issues spend in a particular status

  • Last Comment - view the latest comment for each issue

Once you've added your columns, you can aggregate the data up the structure. To do so, open the column you want to aggregate and select Sum over sub-items.

Looking to manage resources for your next project? Planner makes it easy to plan resources and capacity for your team.


Resource Allocation

When team members are working on multiple projects, it can be difficult to track how much work everyone is doing. Using Structure, you can track allocation across projects and reassign work on the fly.

Step 1: Build a Resource Allocation Structure

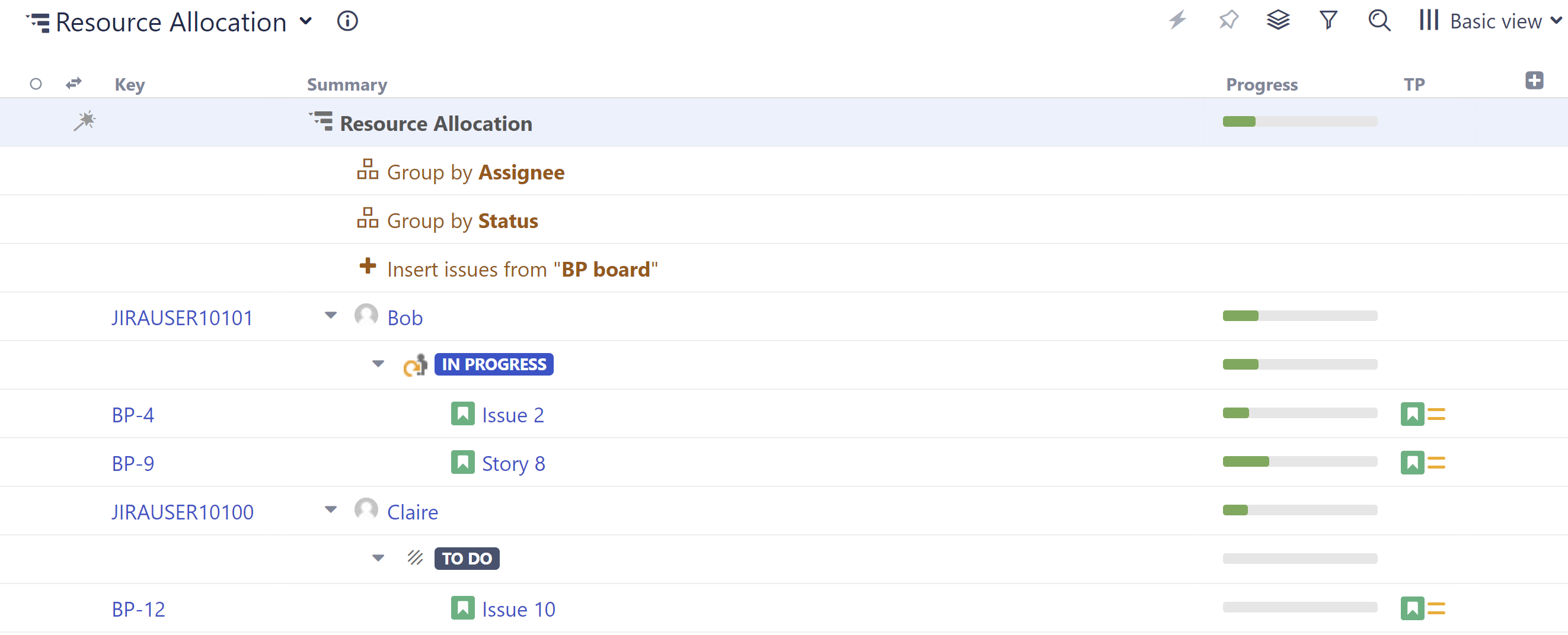

Insert issues from every project/board the team members work on, and then group them by Progress and Assignee.

To create a new structure:

  1. Go to the Jira menu and select Structure | Create Structure
  2. Add all the issues: Automation | Insert
    • Select Agile Board to add issues from select boards
    • Select JQL Query to add issues from projects, using JQL
  3. Group issues by Status: Automation | Group | type "Status"
  4. Group issues by Assignee: Automation | Group | type "Assignee"

If the status is appearing above the assignee, drag the "Group by Status" row under the "Group by Assignee" row.

This will create a grouping for every team member with at least one issue in the current structure assigned to them. If someone doesn't have any issues assigned to them, they won't appear here. To fix this, simply assign an unassigned issue to that team member, and a new grouping will appear.

Step 2: Add Columns to Compare Workloads

Structure columns allow you to visualize multiple data points in a single view. We recommend one or more of these:

  • Status
  • ∑ Story Points (if you’re using them)
  • ∑ Original Estimate
  • ∑ Remaining Estimate
  • A custom formula to calculate the remaining effort

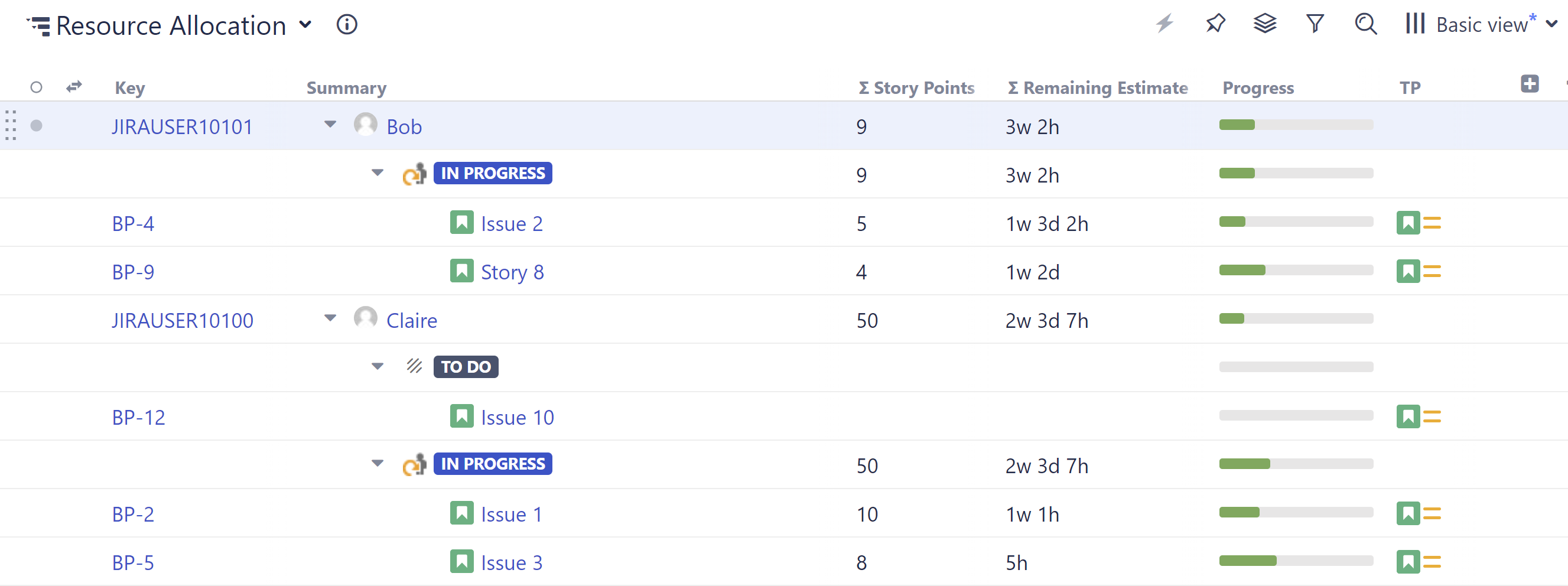

Using a Totals columns, the values for individual issues are aggregated up to their assignee, so you can evaluate workloads at a glance.

Step 3: Drag Issues to Reassign

To assign/reassign tasks, simply drag issues from one assignee grouping to another.

Optional Enhancements:

  • To allocate resources at the group level, group issues by a custom Team field instead of Assignee.
  • Add a WSJF column to prioritize issues, and select Sum over sub-items to balance priorities across resources.
  • Manage allocation across sprints by adding a Group by Sprint generator. (Haven't assigned sprints yet? Check out Sprint Planning with Structure!)
  • Try Planner by Tempo to plan resources and capacity for your team.

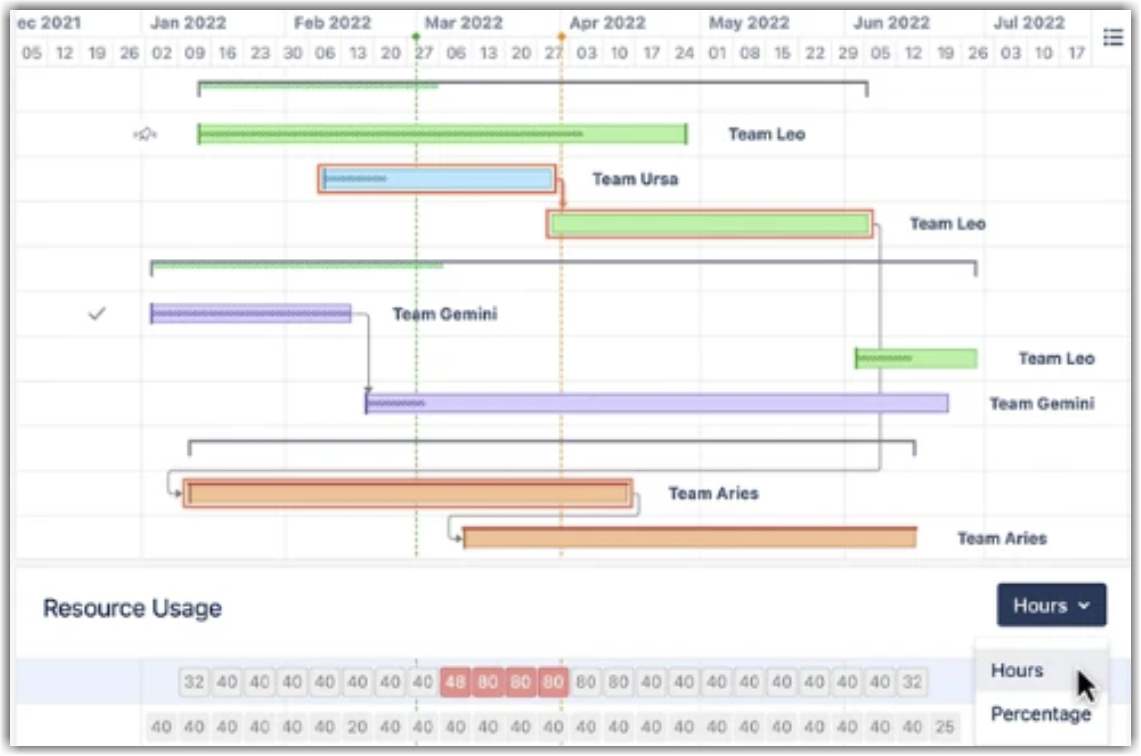

Adding Structure.Gantt makes it easy to identify and resolve overallocations across projects and portfolios.

Sprint Planning

With Structure, you can track all the issues for upcoming sprints – even if they're from different projects – and visualize all the data you need to track on a single screen. You can even aggregate that data for each sprint.

Step 1: Build a Sprint Planning Structure

To create a new structure:

  1. Go to the Jira menu and select Structure | Create Structure
  2. Add all the issues from a Board: Automation | Insert | Agile Board
  3. Group by sprints: Automation | Group | type "Sprint..."

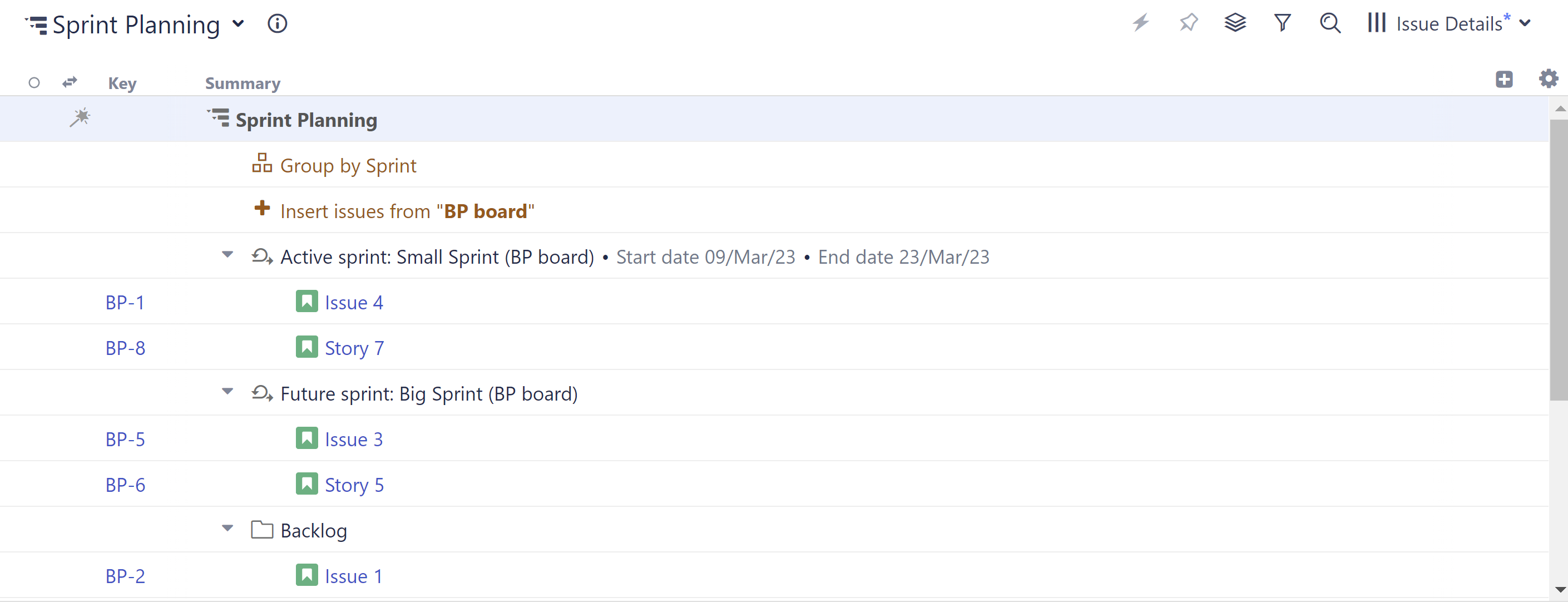

  4. Open the Summary settings and select "Show Sprint and Version attributes":

Step 2: Add Data

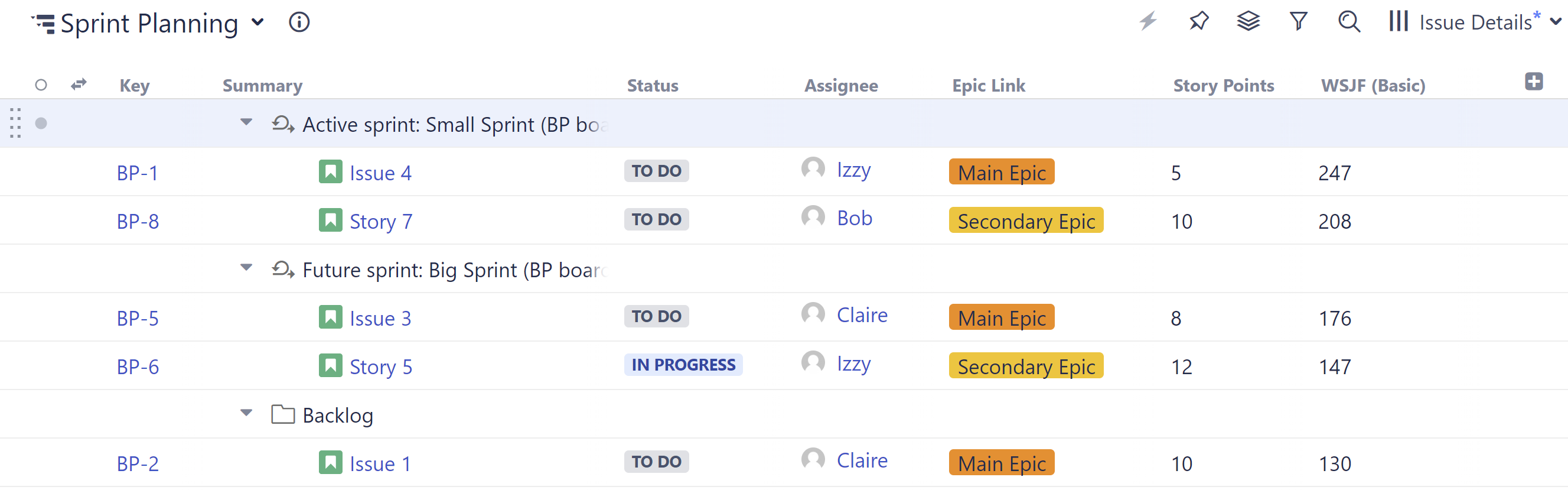

Next, add the data you'll use to compare issue priority:

  1. Click the button at the top-right corner of the structure
  2. Select the fields or attributes you want to compare - we recommend:
    • Status
    • Assignee
    • Epic Link

    • Story Points (if you’re using them)
    • WSJF (or any other metric your team uses to prioritize issues or assess business value)
  3. Click the header of any column to sort your issues by that value.

Step 3: Assign Issues

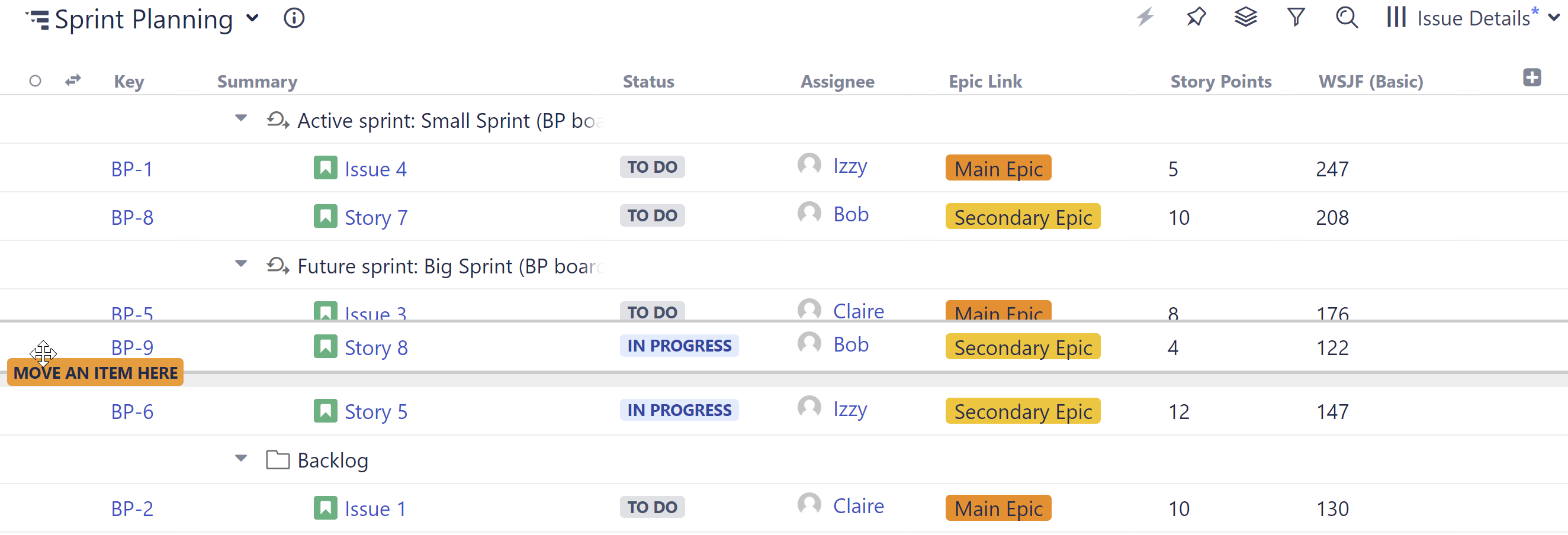

To assign issues to a sprint, drag it from the backlog to the appropriate sprint. You can also reassign issues by dragging them from one sprint to another.

Optional Enhancements

  • Aggregate values for each sprint: when adding a column (such as Story Points), select Sum over sub-items
  • Group by assignee under each sprint to see how the work is divided across your team: Automation | Group | Assignee

  • Hide closed sprints: Automation | Filter | Hide Closed Sprints

  • Use Structure.Gantt to view any blocking dependencies between issues (to help prioritize them)
