Sample Formulas

Analytics

Calculate time needed to burn down the backlog

Assuming your team can accomplish 10 story points a week, this will tell us how long (in weeks) it will take to burn down work and get to certain items further down the backlog. To adjust how many story points the team can work in a week, simply change the "velocity" value.

CODE
WITH velocity = 10:
  CONCAT(SUM#preceding{story_points} / velocity, "w")

For this example to work most effectively, the structure should be sorted based on how you choose which work to complete first. See Sort Generators for more information.

Calculate days past due

This example checks for items that are overdue and returns the number of days the item is overdue.

CODE
IF dueDate < NOW():
   DAYS_BETWEEN(dueDate, NOW()) CONCAT " days late"

Compare the original estimate to work logged and the remaining estimate

CODE
IF originalEstimate:
    (timeSpent + remainingEstimate) / originalEstimate
ELSE:
    "not estimated"

Calculate the interquartile range of story point estimates

CODE
WITH points = ARRAY { storyPoints } :   // Holds all the story points of the children.
  QUARTILE(points, 3) - QUARTILE(points, 1)

Items and Properties

Access an item property

Use the following format: item.property

The following returns the release date for each fix version:

CODE
fixVersions.releaseDate

Note: if the fix version field contained multiple values, multiple dates will be returned.

For a list of accessible item types and their properties, see Item Property Reference.

See how many sprints an issue has been added to

CODE
sprint.size()

JQL

Identify recently created issues

This example identifies issues created within the past 4 weeks.

CODE
IF JQL{created > "-4w"}:
  "scope creep"

To look at issues made more or less recently, update the "4w"; to display a different notification, change the "scope creep" text.

Markdown

Change Text Color

This example uses color-coded text to let users know when issue due dates are approaching (or overdue).

CODE
IF dueDate < today():
  ":panel[OVERDUE]{color=red}"
ELSE IF DAYS_BETWEEN(today(), dueDate) <= 7:
  ":panel[Due Soon]{color=green}"
ELSE IF DAYS_BETWEEN(today(), dueDate) > 7:
  ":smile:"
ELSE:
  ":panel[Needs Due Date]{color=blue}"

Change Background Color

This example changes the background color of the cell, according to the status category, and returns the summary text for each issue.

CODE
WITH format(text, color) = """:panel[${text}]{backgroundColor=${color}}""" :

CASE(status.category,
  "To Do", format(summary, "gray"),
  "In Progress", format(summary, "blue"),
  "Done", format(summary, "green")
)

You can easily customize this by changing the return value, altering the colors, or combining this effect with a larger formula.

Try experimenting with text and background color combinations - this can be a great way to draw attention to key data points.

Customizable Progress Bars - Based on a Custom Progress Field or Function

The following formula creates custom progress bars based on a custom progress field or user function.

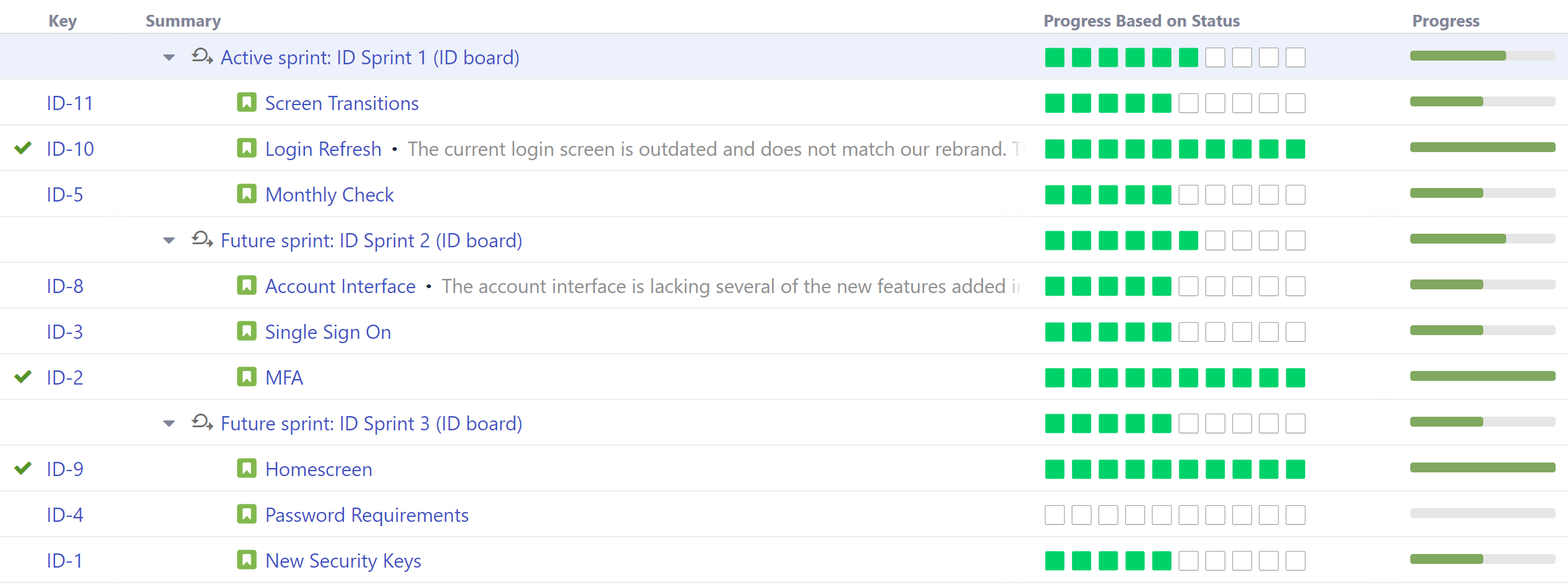

Structure with custom progress bars based on issue status

Structure with custom progress bars based on issue status

We used the following formula to build the custom progress bar:

CODE
WITH simpleProgressBar(progress, maxProgress, stepCount) = (
  WITH _bars(count, emoji) = REPEAT(emoji, count):
  WITH doneBarsCount = FLOOR(progress / maxProgress * stepCount):
    _bars(doneBarsCount, ":green_square:") CONCAT _bars(stepCount - doneBarsCount, ":white_large_square:")
):


simpleProgressBar(customProgress, 1, 10)

Starting with this, you can tailor the progress bar to your team's particular needs.

  • Colors can easily be configured by altering the "color" values - in this case, we used green and white squares.

  • The stepCount value can be adjusted depending on how many squares you want to visualize.

  • The progress calculation (customProgress) can be based on a custom field or custom user function. In the following example, we added a custom user function to mimic the default calculation in our Progress by Status column:

CODE
WITH simpleProgressBar(progress, maxProgress, stepCount) = (
  WITH _bars(count, emoji) = REPEAT(emoji, count):
  WITH doneBarsCount = FLOOR(progress / maxProgress * stepCount):
    _bars(doneBarsCount, ":green_square:") CONCAT _bars(stepCount - doneBarsCount, ":white_large_square:")
):


WITH customProgress = AVG {CASE(Status; "Done"; 1; "In Progress"; .5; "To do"; 0)}:
simpleProgressBar(customProgress, 1, 10)

Customizable Progress Bars - Based on Status Categories

The following formula calculates progress based on the Status Categories of the issue and its children.

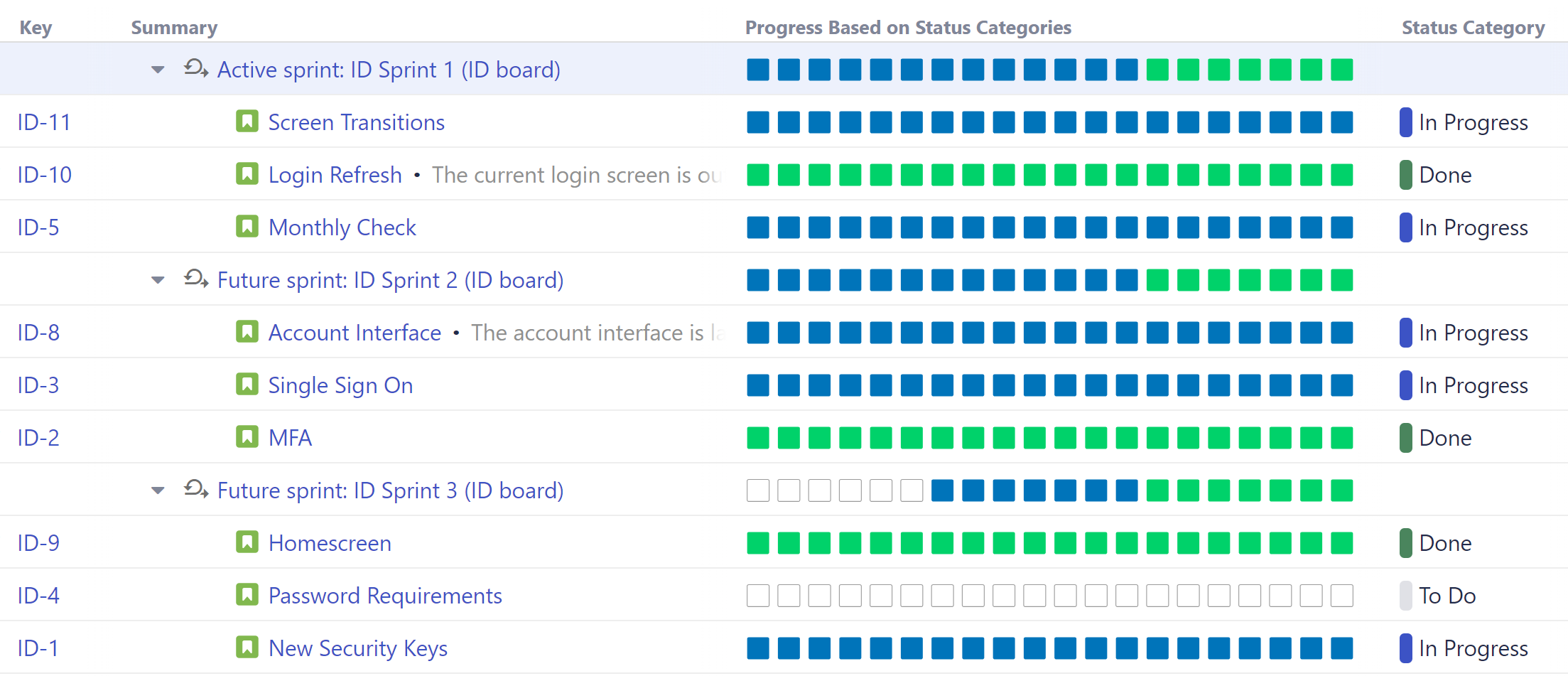

Structure with custom progress bars based on status categories

Structure with custom progress bars based on status categories

CODE
WITH multiProgressBar(progressArray, maxProgress, emojiArray, stepCount) = (
  WITH _bars(count, emoji) = (IF count > 0: REPEAT(emoji, count) ELSE ""):
  WITH barCountsWithInitial =
    ARRAY(
      ARRAY(ARRAY(ARRAY(0, maxProgress, stepCount))),
      progressArray)
   .FLATTEN() // imitate foldl with initial value
   .REDUCE( (prevArray, p) ->
 	WITH s = prevArray.LAST().get(1):
  	WITH k = prevArray.LAST().get(2):
  	WITH pCount = if (s = 0; 0; FLOOR(p / s * k)):
  	WITH newElement = ARRAY(pCount, s - p, k - pCount):
  	ARRAY(prevArray, ARRAY(newElement)).FLATTEN())
   .MAP(a -> a.get(0)):
  WITH barCounts = barCountsWithInitial.SUBARRAY(1, barCountsWithInitial.SIZE()):
  progressArray.INDEXES()
	.MAP(_bars(barCounts.GET($), emojiArray.GET($)))
	.JOIN("", "", "")
):
WITH all = COUNT#truthy { statusCategory }:
WITH todo = COUNT#truthy { statusCategory = "To Do" }:
WITH inProgress = COUNT#truthy { statusCategory = "In Progress" }:
WITH done = COUNT#truthy { statusCategory = "Done" }:
multiProgressBar(
  ARRAY(todo, inProgress, done), all,
  ARRAY(":white_large_square:", ":blue_square:", ":green_square:"),
  20
)


Users

Show everyone who worked on the task

CODE
ARRAY(reporter, assignee, developer, tester)

Note: developer and tester are custom fields - they will be automatically mapped only if those custom fields exist in your Jira instance.

Show everyone who worked on any task in the subtree

CODE
VALUES { ARRAY(reporter, assignee, developer, tester) }

Note: developer and tester are custom fields - they will be automatically mapped only if those custom fields exist in your Jira instance.

Versions

Check for a specific fix version

CODE
fixVersions.CONTAINS("v1")

If the issue contains that fixVersion, returns 1 (true). Otherwise, returns 0 (false).

Get the latest/earliest fix version

CODE
fixVersions.UMAX_BY($.releaseDate) // latest


fixVersions.UMIN_BY($.releaseDate) // earliest

Find the largest time span of an affected version

CODE
affectedVersions.MAP(IF $.releaseDate AND $.startDate: $.releaseDate - $.startDate).MAX()

For each Affected Version, subtracts the Start Date from the Release Date, and returns the Affected Version with the largest result.

Want the shortest result? Change MAX to MIN.

Show all versions referenced in the subtree

CODE
VALUES { ARRAY(fixVersions, affectedVersions).FLATTEN().UNIQUE() }

Get all fix versions with future release dates

CODE
fixVersions.FILTER($.releaseDate AND $.releaseDate > NOW())

Show all released affected versions

CODE
affectedVersions.FILTER($.isreleased)

Show all issues released during a set period of time

CODE
DATE(“0/Jan/2021”) < fixVersion.releaseDate

   AND fixVersion.releaseDate < DATE (“31/Mar/2021”)

Check that child issues and paret issues have the same Fixversion

CODE
with parentVersion = PARENT{FixVersion}:
  if(parentVersion and !parentVersion.contains(fixVersion); "version mismatch")
